Sprint backlog

Use a sprint backlog to follow committed and completed work, see the burndown, and review the stories, bugs, and tasks assigned to the sprint.

The address is /p/:key/sprints/:sprintId/backlog.

Sprint backlog with committed and completed points, burndown chart, work items, and sprint summary.Sprint backlog with committed and completed points, burndown chart, work items, and sprint summary.

The summary compares committed, completed, and remaining points. The burndown chart shows remaining work across the sprint’s working days against the ideal line. Review the backlog table and the side rail for work by state and team member.

Sprint burndown with ideal and actual remaining work across working days.Sprint burndown with ideal and actual remaining work across working days.

From the sprint menu, open Capacity to edit the points available per person. The capacity view also compares the team total with committed points and velocity.

To review a pending rollover, open Sprints, or open Backlogs, then Stories. ShipLean shows the review there for an ended sprint with unfinished work. It does not appear on this sprint backlog page. Review each unfinished item and choose whether to move it to the next sprint, return it to the top of the backlog, or leave it in the ended sprint. You can set the same choice for all items. Open tasks move with their story. Completed tasks stay in the ended sprint. Choose Apply to record the decisions, or Decide later to close the prompt without applying them.

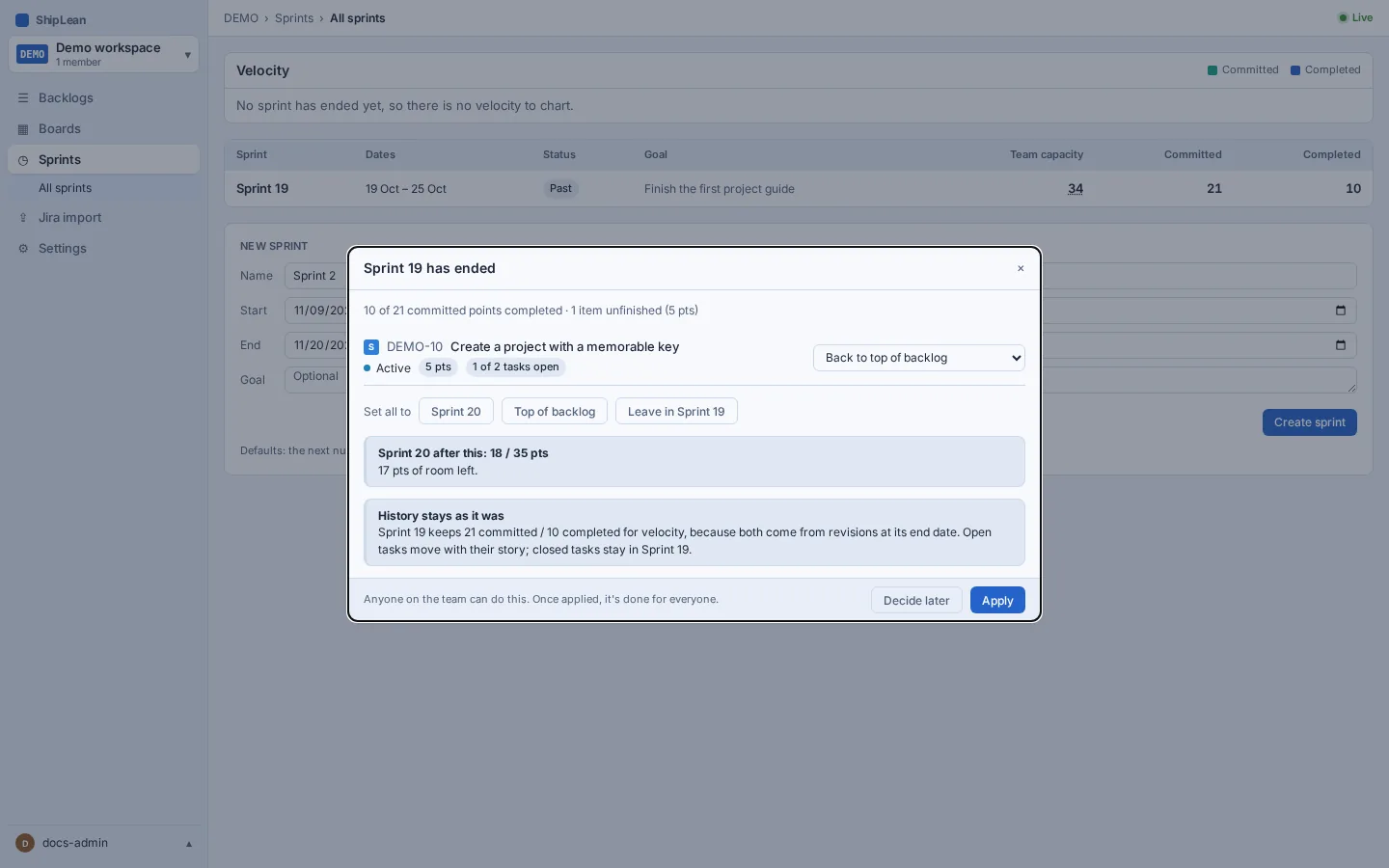

Sprint end review showing unfinished items, rollover choices, and Apply or Decide later.Sprint end review showing unfinished items, rollover choices, and Apply or Decide later.

The ended sprint keeps its committed and completed totals for velocity history. Moving unfinished work does not rewrite those totals.
